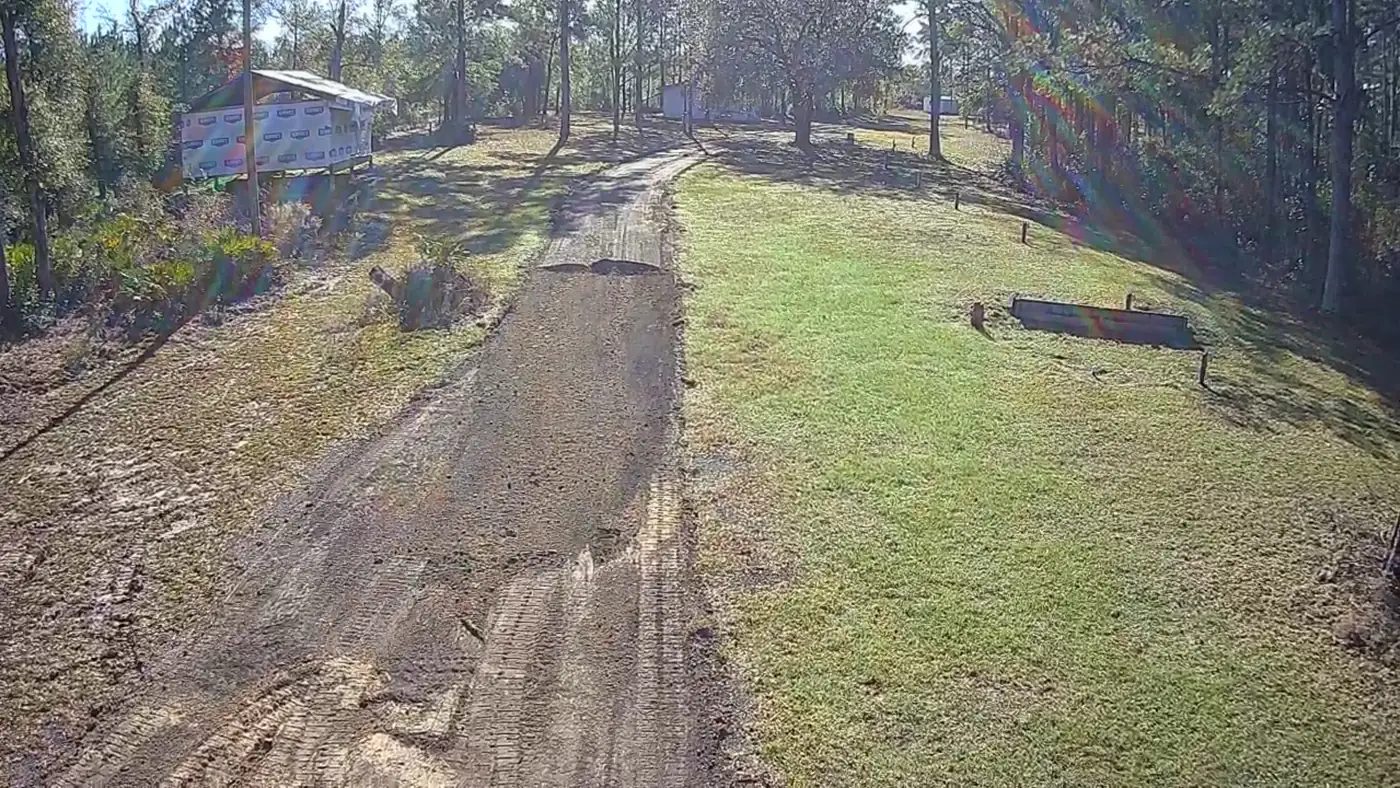

Aerial view of grading and base preparation along a private driveway
All articles

paving planning

Why Grading and Drainage Come Before Asphalt Paving

How surface grades, subgrade and base conditions, runoff paths, inlets, swales, transitions, and wet areas influence an asphalt paving or rehabilitation plan.

Published September 7, 2026Reviewed by Vince Lovell

Asphalt follows the surface built beneath it. If the grade directs water into a low area, the base remains wet, or a transition traps runoff, a new asphalt layer does not remove that condition. Grading and drainage therefore belong near the beginning of pavement planning—not as an afterthought once paving is complete.

Map where water comes from and where it can go

Look beyond the paving limits. Roof drains, irrigation, neighboring grades, slopes, driveways, swales, curbs, inlets, ditches, and roadway drainage can all contribute water. A useful site review observes high points, low points, flow paths, erosion, sediment, staining, vegetation patterns, and areas that remain wet after rain.

The proposed work should not direct runoff toward buildings, accessible routes, adjoining property, or a place without a lawful discharge path. Some drainage conditions require engineering, permits, utility review, environmental review, or coordination with an association or public agency. The paving proposal should identify those dependencies.

Subgrade and base need to support the pavement

Subgrade is the prepared soil beneath the pavement section. The aggregate base distributes load and provides the platform for paving. Soft, pumping, saturated, contaminated, or poorly compacted material can allow settlement and movement above it. Repair limits and preparation methods should be based on site findings.

The Florida Department of Transportation publishes separate current resources for pavement design and drainage. A residential or private commercial project is not automatically an FDOT roadway project, but the separation of pavement and drainage disciplines makes an important point: both need deliberate design and documentation.

Finished elevations must connect to fixed features

  • Garage floors, building entrances, sidewalks, ramps, and loading docks
  • Curbs, gutters, islands, catch basins, manholes, and utility valves
  • Public-road aprons, neighboring pavement, gates, and tracks
  • Landscape edges, retaining features, shoulders, ditches, and swales

These features create elevation constraints. Milling, excavation, base adjustment, curb work, inlet adjustment, or transition paving may be needed to meet them. The written scope should state which features are included and which must remain unchanged.

Standing water does not have one universal fix

A small surface depression may be corrected differently from a blocked inlet, undersized pipe, settled base, flat site, groundwater condition, or off-site restriction. The cause needs to be identified before choosing regrading, repair, drainage installation, or reconstruction. Promising that paving alone will eliminate every puddle is not a reliable scope.

What to document before paving

  1. Existing drainage features and observed problem areas
  2. Proposed grades, flow direction, and fixed elevations
  3. Excavation, unsuitable-material handling, base installation, and compaction
  4. Inlets, pipes, swales, underdrains, or other included drainage work
  5. Permits, utility locations, testing, design, and owner-provided approvals
  6. Conditions that require reevaluation after excavation begins

Use rainfall observations as evidence

Photos taken during or shortly after rain can help document where water collects and how it reaches the pavement. They do not replace measurements or design, but they give the estimator useful context that may not be visible on a dry afternoon.

The company’s grading and drainage service can be coordinated with asphalt paving when both belong in the approved site scope.

Sources and references
