Commercial Parking Lot Paving: A Property Manager’s Planning Checklist

A planning checklist for owners, property managers, HOAs, and facility teams comparing commercial parking-lot paving, resurfacing, repair, drainage, and striping scopes.

Published September 7, 2026Reviewed by Vince Lovell

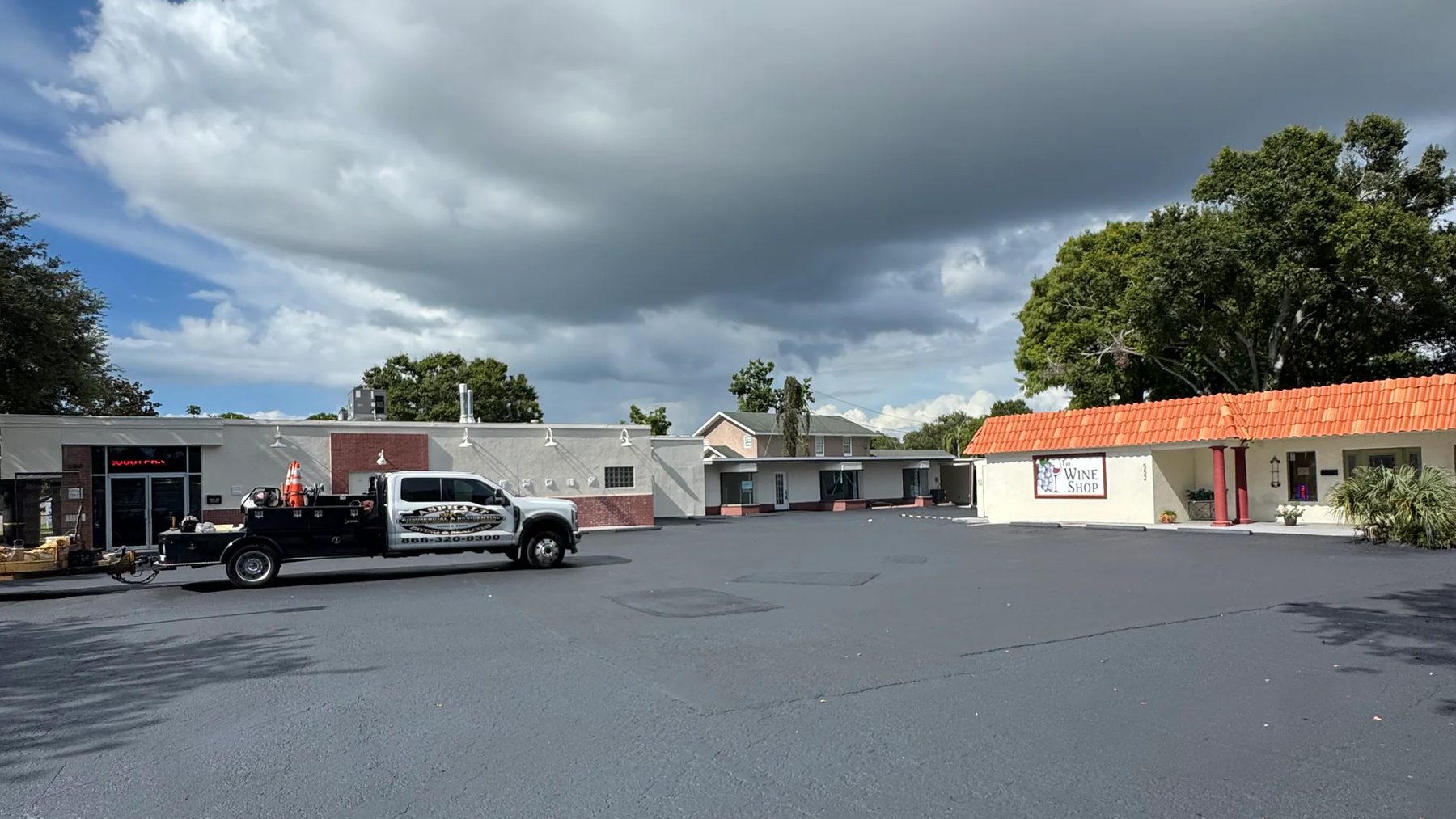

A commercial parking-lot project affects more than pavement. It changes customer access, deliveries, employee parking, pedestrian routes, fire lanes, loading areas, drainage, and the daily operation of the property. The planning work done before mobilization often determines whether the construction phase is understandable or chaotic.

Document the property’s operating constraints first

  • Hours when entrances, drive lanes, loading zones, and tenant spaces must remain available
  • Emergency access, waste collection, deliveries, school or service schedules, and peak traffic periods
  • Pedestrian routes and entrances that need temporary protection or detours
  • Special events, lease requirements, association notices, and approval deadlines

A contractor can propose phases only after learning what cannot close at the same time. Ask for a simple phasing plan that identifies work zones, traffic direction, temporary parking, notification responsibilities, and the conditions required before an area reopens.

Separate pavement condition from appearance

Faded pavement can still be structurally serviceable, while a dark surface can hide base movement or repeated repairs. The evaluation should map potholes, failed patches, alligator cracking, rutting, settlement, utility cuts, ponding, broken edges, and transitions. Each condition should be assigned to repair, milling, resurfacing, reconstruction, or monitoring—not treated as one undifferentiated area.

Review drainage and elevations before choosing the surface scope

Commercial lots contain curbs, islands, inlets, manholes, sidewalks, ramps, doors, loading docks, and neighboring pavement. Adding or removing pavement depth changes how those elevations relate. The proposal should explain how milling, grading, repairs, and transitions will maintain or improve the intended drainage path.

If standing water results from a larger drainage-system problem, paving alone may not correct it. Inlets, pipes, outfalls, swales, or off-site restrictions may require separate investigation or design. Identify that boundary before assuming a new surface will solve every low area.

Confirm the post-paving layout

Do not wait until the striping crew arrives to decide how the lot should work. Obtain or approve the parking layout, accessible spaces and routes, access aisles, crosswalks, fire lanes, loading zones, arrows, curb markings, and specialty stencils before paving is complete. Existing markings should not automatically be copied if the property’s use or applicable requirements have changed.

The U.S. Department of Justice ADA Standards include requirements for accessible parking spaces, access aisles, routes, slopes, and signs. State and local requirements may add other obligations. The property owner should provide an approved layout or engage an appropriate design professional when compliance decisions extend beyond the contractor’s paving and marking scope.

Build a scope that competing bids can answer

  1. Measured work limits and the pavement areas assigned to each treatment
  2. Repair depths, base work, milling limits, and transition details
  3. Materials, cleaning, tack, paving, compaction, and protection steps
  4. Drainage structures, utility covers, curbs, ramps, and concrete interfaces
  5. Traffic control, phasing, reopening conditions, striping, and cleanup
  6. Permits, testing, layout approval, notices, and owner-provided information

Plan the closeout before work begins

The closeout can include a walkthrough, marked punch list, photographs, delivery tickets or other agreed records, approved change documentation, and care instructions tied to the installed materials. Define the requested documentation in the proposal so the property manager is not trying to reconstruct it after the crews leave.

The company’s commercial paving services, grading and drainage work, and parking-lot striping service can be evaluated together in one site-specific proposal.
